China Injection Mold Manufacturer
Injection Mold Making in China

Factory-based custom injection mold engineering and manufacturing for overseas OEM buyers — from DFM review and tooling design to CNC machining, EDM, mold assembly, T1 sampling and production-ready tool delivery.

P20 / 718 / S136 / H13Mold Steel
Single / MultiCavities
CNC / EDMIn-House Tool Room
T0 / T1Mold Trials
Founded 1998 ISO 9001:2015 IATF 16949 DFM Before Steel

ACCEPTED FILES: STEP · IGES · STL · PDF · DWG · DXF

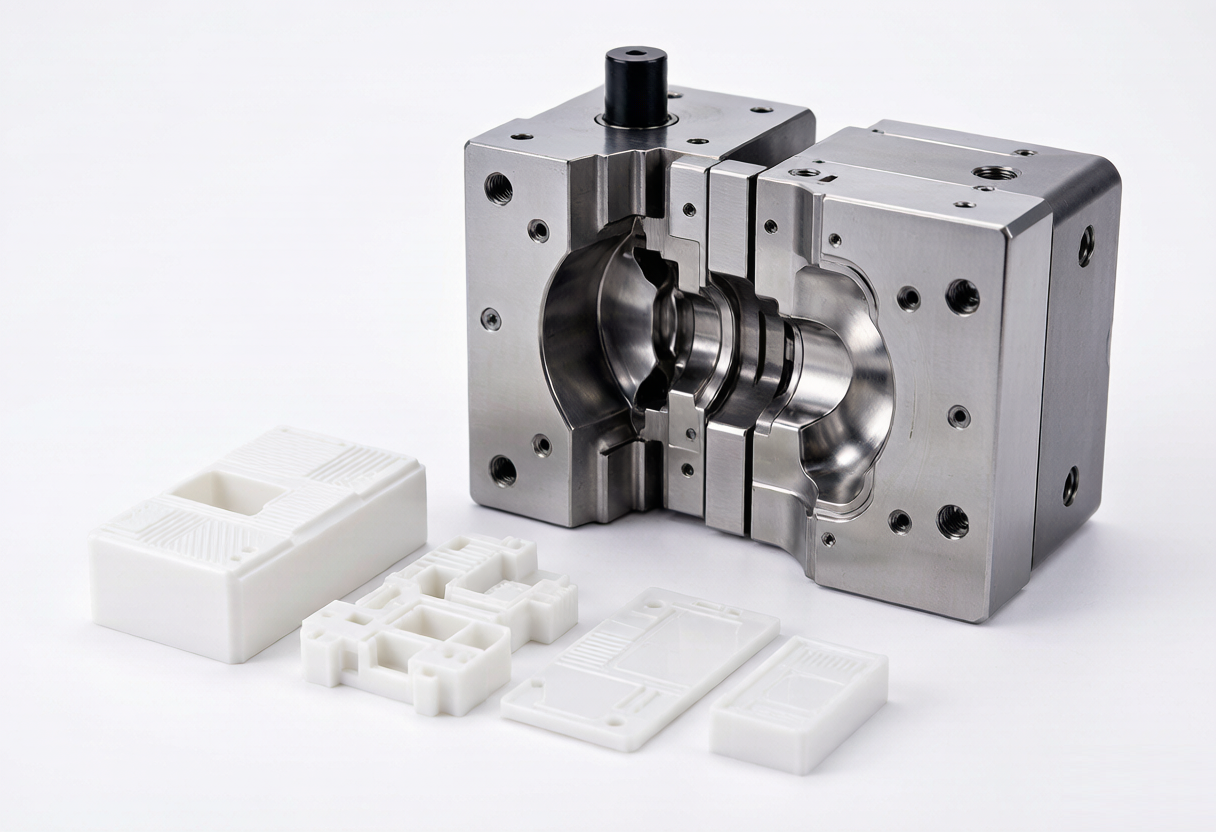

Opened steel injection mold with molded plastic sample parts on white background DFM Before Steel

Most buyers searching "injection mold making China" are not asking "what is a mold." They are choosing a manufacturing partner who can design the tool, prove it before steel is cut, run a credible T1, and hand off a tool that holds up in production. That is what this page is built around.

Supplier Selection

Factory verification, tool room, real mold photos and case evidence — not a polished brochure. You should be able to confirm the maker is a real mold builder.

Engineering & Tooling

DFM review, mold concept, 3D design, steel selection, CNC / EDM machining, fitting and assembly — the full tooling chain handled in one accountable organization.

Validation & Handoff

T0 / T1 / T2 trials, dimensional inspection, mold ownership, maintenance and production handoff so the tool performs when volume starts.

Custom Injection Mold Manufacturing from DFM to T1 Validation

A reliable mold is decided long before the first cavity is cut. The path below is what separates a tooling supplier from a tooling partner.

Customer CADPart drawing
DFM ReviewRisk check
Mold ConceptStructure
3D Mold DesignApproval
Steel SelectionProcurement
ToolingCNC / EDM
AssemblyFitting
T0 / T1 TrialValidation
Sample ApprovalProduction handoff

What Is Injection Mold Making?

Injection mold making is the process of engineering and manufacturing a reusable tooling system that forms a plastic component during injection molding. It is a discipline of its own, distinct from running the press.

Injection Mold MakingInjection Molding
Tool design & engineeringPart production
Mold steel & componentsPlastic resin
Core / cavity machiningInjection cycle
Runner / gate designFilling & packing
Cooling channelsCooling cycle
Ejection systemPart removal
T1 validationProduction repeatability

Keeping these separate matters: a buyer evaluating a mold maker is buying engineering and tooling capability, not press time. This page focuses on the tool; the production process is covered on our injection molding service page.

Why Source Injection Mold Making from China?

The reason is not "cheaper at any cost." It is an integrated, mature tooling supply chain that supports serious OEM programs — when the supplier is genuinely capable.

Integrated Tooling Supply Chain

Mold steel, standard components, CNC, EDM, heat treatment and polishing are concentrated in established clusters, shortening the chain from design to first trial.

Engineering Capability

Experienced tool designers, mold makers, CNC programmers, EDM specialists and fitters support complex structures such as sliders, lifters and multi-cavity tools.

Production Continuity

Mold making can connect directly with injection molding, secondary operations and assembly — one accountable organization for tool and parts.

China Is Not Automatically the Best Choice

Supplier capability matters more than country alone. For extremely low annual volume, frequent design changes or programs needing very local maintenance, other options may fit better. Evaluate the project, not the flag.

How to Verify an Injection Mold Maker in China

A polished website does not prove mold-making capability. Before committing, ask for evidence across the full tooling chain.

Factory location and company registration
CNC and EDM equipment in the tool room
Mold assembly and fitting area
In-house mold trial capability
Inspection equipment (CMM, hardness tester)
Mold steel traceability
Real mold photos, not catalog renders
Actual case studies with parameters
Engineering staff and DFM process
Export and communication experience

Ask specifically for tooling design, machining, EDM, fitting, trial and measurement evidence. The lowest quote from an unverified broker is usually the most expensive tool you will ever buy.

Types of Injection Molds We Manufacture

Each mold type answers a different buying question. The right structure depends on volume, geometry and budget — not a default template.

Prototype

Single-Cavity Mold

Best for prototypes, low volume and product validation where speed and flexibility matter more than cycle cost.

Production

Multi-Cavity Mold

Higher output and lower cost per part for production programs with stable annual volume.

Sync

Family Mold

Related parts molded in one tool for synchronized production and simpler inventory.

Structure

Two-Plate / Three-Plate

Two-plate for standard layouts; three-plate for complex gating and sequential part separation.

Runner

Hot / Cold Runner

Hot runner reduces waste for high volume; cold runner keeps tooling simpler and material changes easier.

Motion

Slider / Lifter Mold

Creates side features and undercuts that a simple two-plate tool cannot release.

Combine

Insert & Overmolding

Combines metals or multiple resins into one molded part for functional or cosmetic value.

Precision

Unscrewing / High-Precision

Threads, tight tolerances and demanding surfaces handled with dedicated mechanisms and tooling.

Decision

Which Should You Choose?

We recommend structure and runner type during DFM, based on part geometry, volume and budget — not a default.

How Many Cavities Should Your Mold Have?

Cavity count is an economic decision, not a status symbol. More cavities is not automatically better.

CavitiesTypical Use
1-CavityPrototype / low volume / validation
2-CavitySmall production runs
4-CavityMedium volume programs
8+ CavityHigh-volume programs
Family MoldRelated parts / synchronized production

Cavity count should be evaluated against annual volume, machine capacity, cycle time, part balance, tooling budget and production economics. We help you size it during the quoting stage.

Injection Mold DFM Review Before Steel Cutting

The goal of DFM is to identify tooling and production risks before machining begins — cheaper and faster to fix on the screen than in hardened steel.

Parting Line

Where the two halves meet — affects flash, appearance and tool cost.

Draft Angle

Enables clean ejection and longer tool life.

Wall Thickness

Balanced walls prevent sink, warpage and short shots.

Ribs & Bosses

Reinforce without trapping stress or sinks.

Undercuts

Determine sliders, lifters or side actions.

Gate & Ejection

Gate location drives weld lines, packing and vestige.

Cooling & Venting

Thermal balance controls cycle and warpage.

Shrinkage

Material-specific allowance built into the cavity.

Texture & Finish

Surface requirements affect steel and polish route.

Injection Mold DFM Checklist

A practical DFM pass we run before tooling approval. Use it to compare suppliers.

Parting line reviewed
Draft angles reviewed
Wall thickness checked
Rib / boss geometry checked
Undercuts identified
Gate location reviewed
Runner system selected
Cooling strategy reviewed
Ejection system reviewed
Venting reviewed
Steel selected
Cavity count confirmed
Mold maintenance considered
Cosmetic surfaces identified

Gate, Runner, Cooling and Venting Design

Mold making is not simply milling a cavity. Flow design decides whether a tool runs cleanly at volume.

Gate Design

Location and type control filling, weld lines, packing, cosmetics and gate vestige. A poor gate can ruin an otherwise good part.

Runner System

Cold runner for simplicity and easy material changes; hot runner for lower waste and optimized cycle on the right programs.

Cooling System

Channels, baffles and bubblers manage thermal balance — the main lever on cycle time and warpage.

Venting

Air evacuation prevents burn marks, short shots and trapped-gas defects at the last place the cavity fills.

Hot Runner vs Cold Runner Injection Molds

There is no universal winner. The best runner system depends on resin, part geometry, volume, appearance and tooling budget.

FactorHot RunnerCold Runner
Material WasteLowerHigher
Tooling CostHigherLower
CyclePotentially optimizedStandard
MaintenanceMore complexSimpler
High VolumeOften attractiveDepends
Material ChangesMore difficultEasier

Injection Mold Steel Selection

Steel choice is a trade-off between mold life, resin, cosmetics, corrosion and budget. There is no single "best" steel.

SteelTypical Use
P20General production tooling
718General use with better polishability
S136Corrosion resistance / high cosmetic requirements
H13High wear / demanding applications
NAK80High-quality surface applications

Steel is selected against expected mold life, resin abrasiveness, cosmetic requirements, corrosion exposure, production volume and maintenance expectations — confirmed during DFM, not guessed.

Injection Mold Life and Tool Classes

Tool life depends on steel, resin, cycle conditions, maintenance, part geometry and production volume — not a single number you can paste on every quote.

Prototype / Short-Run Tool

Optimized for speed and validation; lower shot target, faster to revise.

Production Tool

Balanced steel and structure for stable serial production.

High-Volume Tool

Higher-grade steel, hardened components and maintenance plan for long campaigns.

Representative industry benchmarks such as 100K / 500K / 1M shots describe tool classes, not promises. Final life depends on design, material and care; confirm against your program in the quotation.

Injection Mold Components and Structure

Understanding the structure helps you read a mold quote and ask the right questions.

CavityForms external geometry
CoreForms internal geometry
RunnerTransfers molten resin
GateControls resin entry
CoolingControls mold temperature
EjectorRemoves the part
SliderCreates side features
LifterHandles undercuts
InsertReplaceable tooling feature
Guide SystemAlignment & repeatability
Hot RunnerControlled melt delivery
Mold BaseStructural foundation

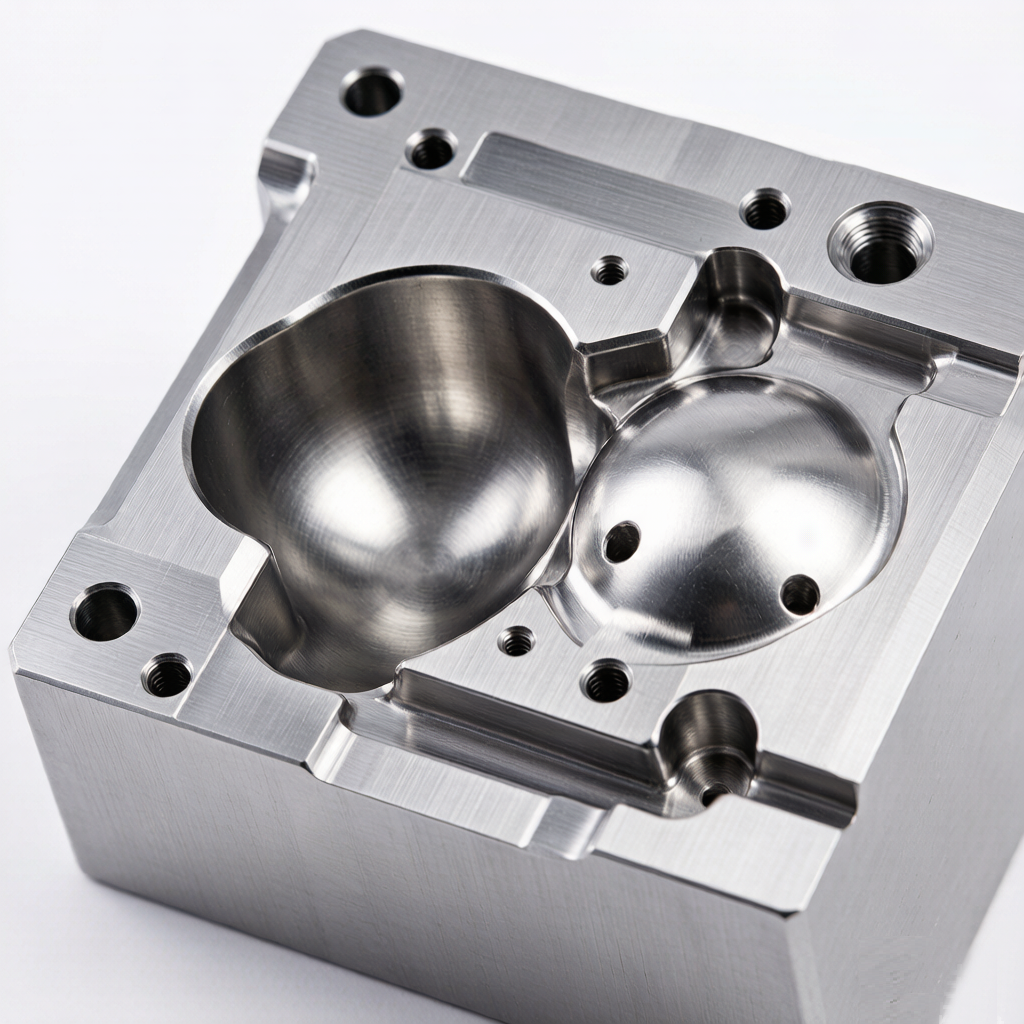

Macro view of a polished injection mold cavity and core steel surface

Our Injection Mold Making Process in China

A complete tooling chain — from first review to packed shipment. Stages reflect a typical program and are adjusted to your part and volume.

01 · RFQ & Part ReviewEvaluate CAD, volume, resin and target life.
02 · DFM AnalysisIdentify tooling and production risk before steel.
03 · Mold ConceptStructure, runner type and motion strategy.
04 · 3D Mold DesignFull tool design for customer approval.
05 · Steel & ComponentsProcure mold steel and standard parts.
06 · Rough CNC MachiningRough out cavity, core and inserts.
07 · Precision CNCFine machining to tolerance.
08 · EDM / Wire EDMDeep ribs, sharp features, tight profiles.
09 · Heat TreatmentHarden where the design requires it.
10 · Grinding / PolishingFlatness, fit and surface finish.
11 · Fitting & AssemblyBuild the complete tool.
12 · T0 / T1 TrialFirst molding and formal validation.
13 · Measurement & AnalysisCheck dimensions, fit and appearance.
14 · Correction / AdjustmentSteel modification or process tuning as needed.
15 · Final ValidationProduction-ready tool sign-off.
16 · Packing & ShipmentProtective packaging and export.

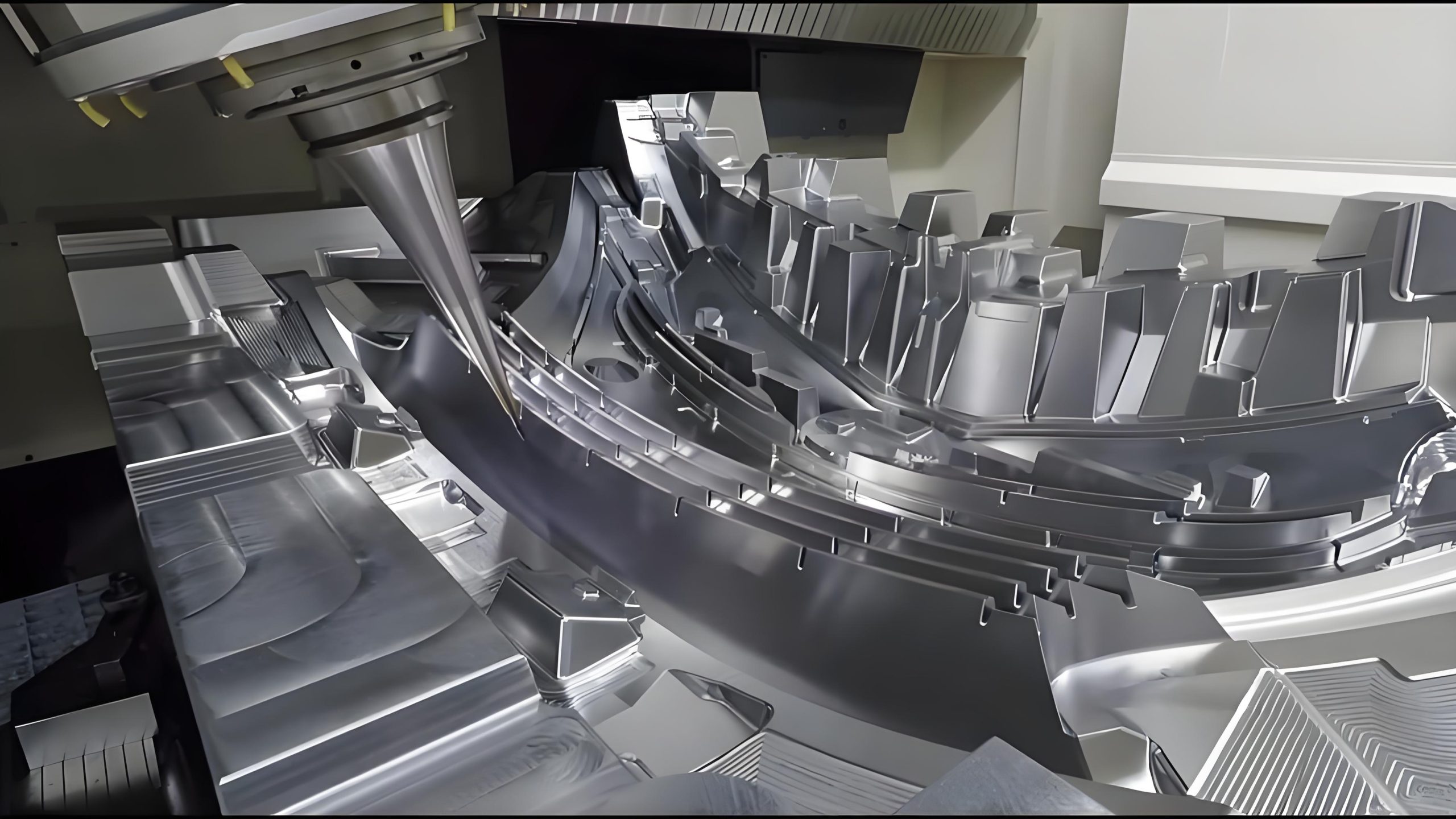

CNC milling machine cutting a steel mold insert

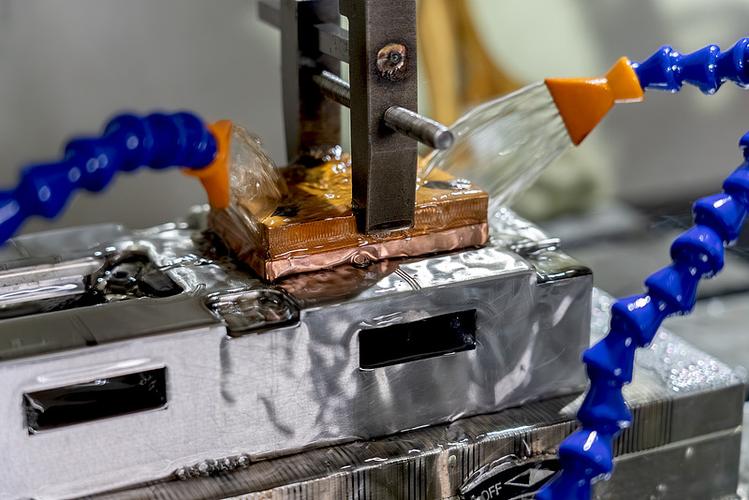

Wire EDM cutting a precision mold component
Mold maker fitting and assembling an injection mold

CNC, EDM, Wire EDM and Mold Fitting

Each process solves a different geometry problem. Knowing which equipment handles what tells you whether a shop can actually build your tool.

CNC Machining

Mold base, cavity, core and inserts — the structural backbone of the tool.

EDM

Deep ribs, sharp features, hardened steel and complex cavities milling cannot reach.

Wire EDM

Precise profiles, inserts, thin features and tight geometries.

Grinding & Fitting

Flatness, dimensional precision, surface quality and final assembly.

T0, T1 and T2 Mold Trials

Trials are where the tool is proven. We do not promise "T1 always passes" — real development sometimes needs correction, and honest trials beat optimistic claims.

T0 — First Trial

Checks mold movement, basic filling, ejection and major defects. A learning run, not a validation.

T1 — Formal Validation

Checks dimensions, appearance, fit, shrinkage, warpage, weld lines, flash and assembly against the drawing.

T2 — Re-Validation

Confirms corrections after modification, moving toward a production-ready tool.

Common T1 Mold Problems and Corrections

A key distinction: some T1 problems are mold issues (steel correction), others are process issues (parameters). Not every defect means cutting steel again.

SymptomMold Issue vs Process Issue
Sink MarksWall / gate / cooling (mold) or packing / pressure (process)
WarpageCooling balance (mold) or cycle / temp (process)
FlashParting / clamp (mold) or pressure (process)
Short ShotGate / venting (mold) or fill (process)
Weld LinesGate location (mold) or temp / speed (process)
Burn MarksVenting (mold) or speed (process)
Ejection ProblemsDraft / ejection (mold) or timing (process)
Dimensional VariationShrinkage / steel (mold) or process window (process)

We separate process tuning from steel correction before deciding what to change. That discipline is what protects your tooling budget.

Mold and T1 Sample Inspection

Mold inspection, part inspection and production validation are different checks — conflating them hides risk.

StageWhat Is Checked
Mold InspectionCavity / core dimensions, fit and movement
T1 InspectionPart dimensions against drawing
Assembly ValidationFit and function of the molded part
Production ValidationRepeatability and process stability

T1 molded sample part under coordinate measuring machine with caliper

Injection Mold Ownership, Storage and Transfer

For overseas buyers, tool ownership is a real commercial question — not a footnote.

Who Owns the Mold

Customer-owned tooling. Ownership follows the agreed quotation and purchase contract.

Storage & Maintenance

Molds can be stored and maintained between production runs under a recorded plan.

Transfer

Molds can be transferred to another factory when the contract allows — a practical question we answer clearly.

Repair & Modification

Revision, repair and modification supported across the tool life.

End-of-Life

Disposal or refurbishment handled per agreement when a program ends.

Production Handoff

Tool released into stable production with documentation and inspection records.

Injection Mold Maintenance and Repair

Maintenance is what keeps a tool running — a differentiator many suppliers skip. For repeat production, it protects your uptime.

Cleaning & Lubrication

Routine care of parting, ejector and motion surfaces.

Cooling Channel Care

Descaling and flow checks to protect cycle time.

Slider / Lifter Service

Inspection and adjustment of moving elements.

Gate / Runner Check

Wear and vestige control at the entry point.

Shot & Repair Records

Logged history reduces unexpected tooling downtime.

Corrosion Protection

Storage treatment for idle tools between runs.

How Much Does Injection Mold Making Cost in China?

A single price range is misleading because tooling cost is driven by many factors. Understand the drivers, then evaluate total cost — not just the first quote.

Part & Tool Factors

Part size, complexity, cavities, steel, hot/cold runner, sliders/lifters, inserts, finish and tolerance.

Life & Volume

Target tool life, expected annual volume and tooling standard shape the build.

Validation Scope

T1 / sampling requirements and documentation level affect effort and cost.

Low Initial PriceProduction-Ready Tool
Low upfront costOptimized lifecycle cost
Lower-grade steel may be usedSteel selected for life
Minimal DFMRisk reviewed before tooling
Basic trialT1 / T2 validation
May need more repairDesigned for repeatability
Limited documentationBetter tooling records

The cheapest mold quote is not necessarily the lowest-cost tooling solution. A low tooling price can cost more through repeated corrections, poor cycle performance or weak maintenance support.

Injection Mold Making Lead Time

Lead time is the sum of stages — and varies widely with complexity. The ranges below are typical planning references; your program's actual timeline is confirmed at quotation.

StageTypical Time*
DFM2–4 days
Mold Design5–10 days
Steel Procurement5–10 days
Machining10–20 days
EDM / Wire EDM5–10 days
Assembly3–5 days
T13–5 days
ModificationPer correction

* Typical planning ranges based on industry benchmarks; final schedule depends on part complexity, steel availability and validation scope. We provide a project-specific timeline with the quote.

Injection Mold Applications

Tooling is selected around the part's function and the industry's demands. We describe applications only where we have relevant capability and case experience.

Automotive

Interior components, lighting parts, housings and brackets with tight appearance and durability requirements.

Electronics

Enclosures, connectors and switch components where fit and cosmetics matter.

Medical

Housings and precision plastic components, with appropriate documentation where applicable.

Consumer Products

Handles, covers and housings for everyday goods.

Industrial Equipment

Housings, brackets and covers for machinery and fixtures.

New Energy

Battery components, electrical housings and cooling-related parts.

Custom Injection Mold Case Studies

Generic capability claims mean little without specifics. These are representative tooling projects described by material, structure, application, challenge and outcome.

2-Cavity Electronics Enclosure Mold

Material
PC/ABS
Cavity
2
Steel
S136
Features
Sliders + texture

Challenge: Tight cosmetic requirements on a textured surface.

Solution: Gate and cooling optimization with texture route planned before steel.

Automotive Multi-Cavity Mold

Material
PA+GF
Cavity
Multi
Features
Sliders + texture
Volume
High-volume

Challenge: Stable output at production volume.

Solution: Balanced cavities and cooling for consistent cycle and fit.

Precision POM Gear Mold

Material
POM
Cavity
Multi
Focus
Tight dimensions
Volume
Production

Challenge: Dimensional control on a precision gear.

Solution: Shrinkage allowance and measurement built into validation.

Finished injection mold beside stacks of molded plastic production parts

What Should You Include in a Mold RFQ?

The more complete your RFQ, the more accurate the quote and the fewer surprises at T1.

Required

  • 3D part CAD (STEP / IGES)
  • 2D drawing with tolerances
  • Material and resin grade
  • Annual volume
  • Target tool life
  • Target delivery

Recommended / Helpful

  • Surface finish and part color
  • Critical dimensions and assembly needs
  • Preferred mold standard
  • Existing sample or reference mold
  • Production location and target cycle time
  • Need injection molding after tooling? (Yes / No / Not sure)

New Mold or Existing Mold Transfer?

New product → new mold. Existing tool in poor condition → repair / modification. Supplier change → mold transfer + inspection. Part revision → mold modification or new insert. If you are not starting from zero, tell us — it changes the plan.

Frequently Asked Questions

How much does injection mold making cost in China?

Tooling cost is driven by part size, complexity, cavities, steel, runner type, sliders/lifters, finish, tolerance, target life and validation scope. We quote on your specific part rather than a generic range, and we focus on total lifecycle cost, not just the first price.

How long does it take to make an injection mold in China?

A typical program runs through DFM, design, steel procurement, machining, EDM, assembly and T1. Planning ranges total roughly 4–8 weeks for many tools, but complex multi-cavity or high-precision tools take longer. Your confirmed timeline comes with the quote.

How do I find a reliable injection mold maker in China?

Verify the factory: tool room, CNC/EDM equipment, mold trial capability, inspection equipment, real mold photos and case studies. Ask for evidence of engineering and DFM, not just a brochure. A low quote from an unverified broker is a risk.

What mold steel should I choose?

It depends on expected life, resin abrasiveness, cosmetics, corrosion exposure and budget. P20/718 suit general production, S136 for corrosion and cosmetics, H13 for wear, NAK80 for high surface quality. We recommend during DFM.

How many cavities should my mold have?

Match cavities to annual volume, machine capacity, cycle time and budget. 1 cavity for validation, multi-cavity for volume. More cavities is not automatically better — it raises tooling cost and complexity.

What is the difference between hot runner and cold runner molds?

Hot runner lowers material waste and can optimize cycle for high volume but costs more and is more complex to maintain. Cold runner is simpler and easier for material changes. The right choice depends on resin, geometry, volume and budget.

What is DFM in injection mold making?

DFM (Design for Manufacturability) reviews parting line, draft, wall thickness, ribs, undercuts, gate, cooling and venting before steel is cut, so tooling and production risks are found on screen — cheaper and faster than in hardened steel.

What happens during a T1 mold trial?

T1 is the formal first validation: dimensions, appearance, fit, shrinkage, warpage, weld lines, flash and assembly are checked against the drawing. It confirms whether correction is needed before production release.

How many mold trials are usually required?

It varies. Some tools pass cleanly; others need T2 after correction. We separate process tuning from steel correction to avoid unnecessary rework, but we do not promise T1 always passes.

Can you modify the mold after T1?

Yes. Corrections after T1 are normal — steel modification where the design requires it, or process tuning where parameters are the cause. We document what changed and why.

Who owns the injection mold?

Customer-owned tooling. Ownership follows the agreed quotation and purchase contract. We store, maintain and can transfer the mold when the contract allows.

Can you store and maintain the mold?

Yes. Between production runs we can store the tool and run a recorded maintenance plan — cleaning, lubrication, cooling care and shot records — to reduce unexpected downtime.

Can I transfer my existing mold to your factory?

Yes, where the contract allows. We start with a tool condition review and inspection, then plan repair, modification or trial before releasing it into production.

Can you make molds and produce the plastic parts?

Yes. Mold making plus injection molding in one organization is often the most valuable combination — one accountable partner from tool to parts.

What CAD files are needed for a mold quote?

3D CAD (STEP / IGES / STL), 2D drawing with tolerances, material, annual volume, target tool life and delivery. Reference samples or existing molds help. The more complete the RFQ, the more accurate the quote.

Do you provide mold inspection reports?

Yes. Mold inspection, T1 part inspection and assembly/production validation are documented. Inspection equipment is used for dimensional verification; specific reports are provided per project scope.

Can you manufacture molds for automotive / electronics / medical parts?

We support these applications where we have relevant capability and case experience, including enclosures, connectors, automotive components and precision parts. Tell us your industry and requirements so we can confirm fit.

How do I verify a China injection mold manufacturer?

Ask for factory location, equipment, tool room, trial capability, inspection, steel traceability, real mold photos, case studies and engineering staff. Verify capability, not just price — supplier capability matters more than country alone.

Why Goldcattle for Custom Injection Mold Projects?

Founded in 1998, with in-house CNC / EDM tooling, material range, prototype support, T1 validation, inspection and injection molding integration — best suited for buyers who need both tooling and downstream manufacturing support.

Founded1998
ToolingCNC / EDM In-House
ValidationT0 / T1 Trials
CertificationISO 9001:2015
Request an Injection Mold Quote

Send your CAD and drawing. We review DFM, propose structure and runner type, and return a project-specific quote and timeline.

ACCEPTED FILES: STEP · IGES · STL · PDF · DWG · DXF

Recommended Reading
